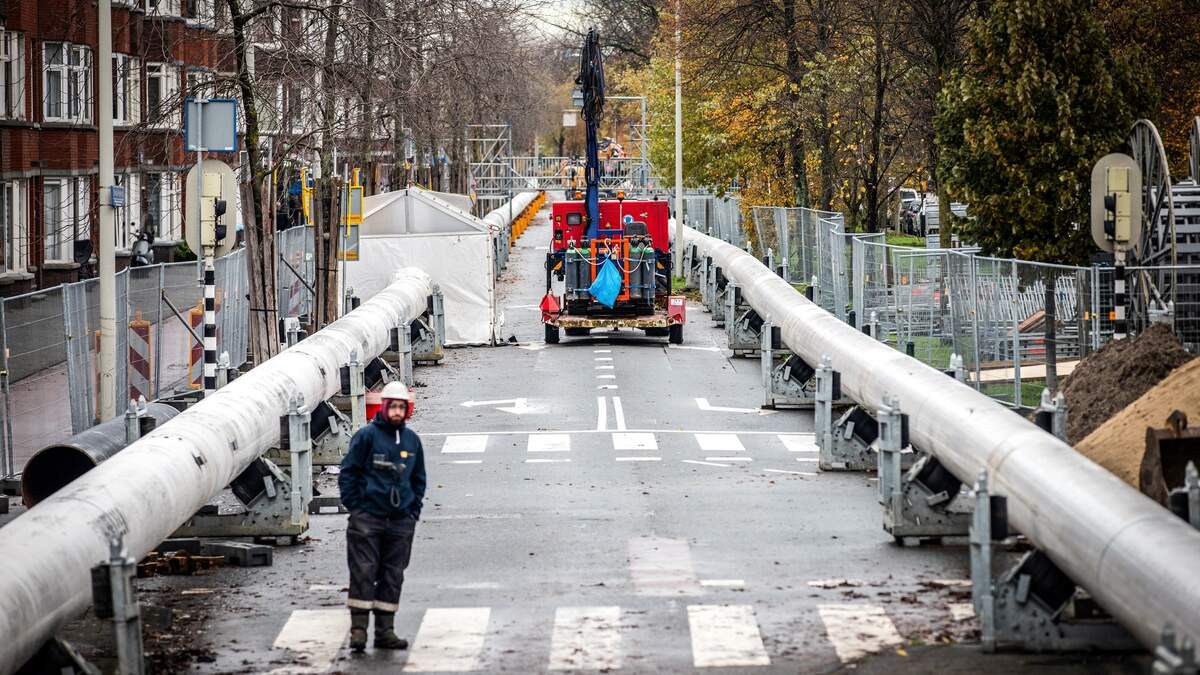

Rotterdam Waste Heat Pipeline to Heat 120,000 Homes
- A 23-kilometer industrial heat pipeline running between Vlaardingen and Den Haag began its testing phase, marking a milestone for the WarmtelinQ project designed to supply waste heat from...
- Workers filled the main transport line with 16 million liters of oxygen-free water to prevent pipe corrosion, a five-week process that kicks off the system check after four...
- Political, financial, and technical resistance slowed the rollout, leading to prolonged permitting procedures and legal challenges from Den Haag.
A 23-kilometer industrial heat pipeline running between Vlaardingen and Den Haag began its testing phase, marking a milestone for the WarmtelinQ project designed to supply waste heat from the Port of Rotterdam to households and businesses in Zuid-Holland, De Telegraaf reported. For tens of thousands of households in Zuid-Holland currently heating with expensive natural gas, heating via a heat network comes closer, as the project must ultimately supply heat to potentially 120,000 homes and commercial properties in fourteen connected municipalities.
Pipeline Testing Begins After Years of Delays and Cost Overruns
Workers filled the main transport line with 16 million liters of oxygen-free water to prevent pipe corrosion, a five-week process that kicks off the system check after four years of construction. The project originated as a concept nearly thirty years ago before securing an investment decision in 2021. Construction on the initial segment toward Den Haag started in 2022 and is largely finished, while the subsequent connection toward Leiden encountered delays that pushed its launch to the autumn of 2028, four years behind schedule. The new pipeline will soon transport hot water to local heat networks, which heat buildings. The system must first be tested for that,
the spokesperson stated. The construction of the main pipeline does not mean that individual homes are automatically connected.
Budget Growth and State Support for the Infrastructure Project
Political, financial, and technical resistance slowed the rollout, leading to prolonged permitting procedures and legal challenges from Den Haag. Construction costs climbed from circa 650 million to ruim 1,1 miljard euro amid lagging local demand and lower gas price forecasts that complicated the financial model. The national government intervened by committing nearly 200 million euros in additional funding, and the Council of State rejected remaining objections to clear the path for completion. After the State pledged nearly 200 million euros extra and the Council of State dismissed the final objections, the project could proceed after all.
Cost Comparisons and Local Connection Timelines
Recent studies by TNO and Royal HaskoningDHV indicate that the cost of industrial waste heat in the Netherlands sits 50 percent lower than natural gas, with expenses decreasing as network scale expands. The main pipeline supplies heated water to local distribution networks rather than individual buildings, meaning municipal authorities decide which neighborhoods transition to the system. The prospective Leiden extension targets approximately 50,000 potential users, and the first official heat deliveries are scheduled for 2027.
